Project planning - Planning and managing quality

Learning Outcomes

After reading this article, you will be able to explain the purpose and components of a project quality management plan, define and distinguish quality-related key terms, describe how "cost of quality" and quality metrics are used, identify continuous improvement methods, and recognize how to plan and control quality in both predictive and adaptive (agile) projects. You'll be ready to approach related PMP exam questions with confidence.

PMP Syllabus

For PMP, you are required to understand how project quality is planned and managed throughout the project life cycle. This involves the principles, plans, terminology, and methods used to assure and control quality. Focus your revision on:

  • Plan and manage quality (quality management plan, quality assurance, and quality control)
  • Define and interpret "cost of quality" and recognize prevention vs. inspection
  • Identify and use quality metrics and standards
  • Understand continuous improvement techniques (such as Kaizen, Six Sigma, and TQM)
  • Use common quality management tools (checklists, cause-and-effect diagrams, control charts, histograms, etc.)
  • Recognize quality processes in both predictive and agile projects
  • Evaluate the impact of quality activities on project constraints (cost, schedule, scope)
  • Analyze and respond to quality-related scenarios, including compliance with standards and customer requirements

Test Your Knowledge

Attempt these questions before reading this article. If you find some difficult or cannot remember the answers, look more closely at that area during your revision.

  1. Which of the following best describes "cost of quality" in project management?

    • a) The total project cost
    • b) The cost of resources for project execution only
    • c) All costs incurred to prevent, measure, and fix nonconformities to requirements
    • d) The fee paid to quality assurance consultants
  2. On a project with very strict regulatory requirements, which statement best represents your quality planning responsibility as a project manager?

    • a) Plan to resolve quality issues when customers complain
    • b) Treat compliance rules as optional if time constraints are tight
    • c) Plan to ensure all requirements and standards are built in and verifiable
    • d) Assign responsibility for quality entirely to the quality department
  3. Which process focuses on verifying that the actual deliverables meet the agreed-upon quality standards?

    • a) Plan Quality Management
    • b) Control Quality
    • c) Manage Quality
    • d) Validate Scope

Introduction

Quality is a core factor in project success. Project managers must ensure that deliverables are fit for purpose, meet stakeholder requirements, and comply with relevant standards. Planning for quality means defining how to build it in—not simply checking for problems after work is done. This article explains the project quality management plan, cost of quality, continuous improvement, quality metrics, and the tools and techniques essential for effective quality planning and control in predictive and agile projects.

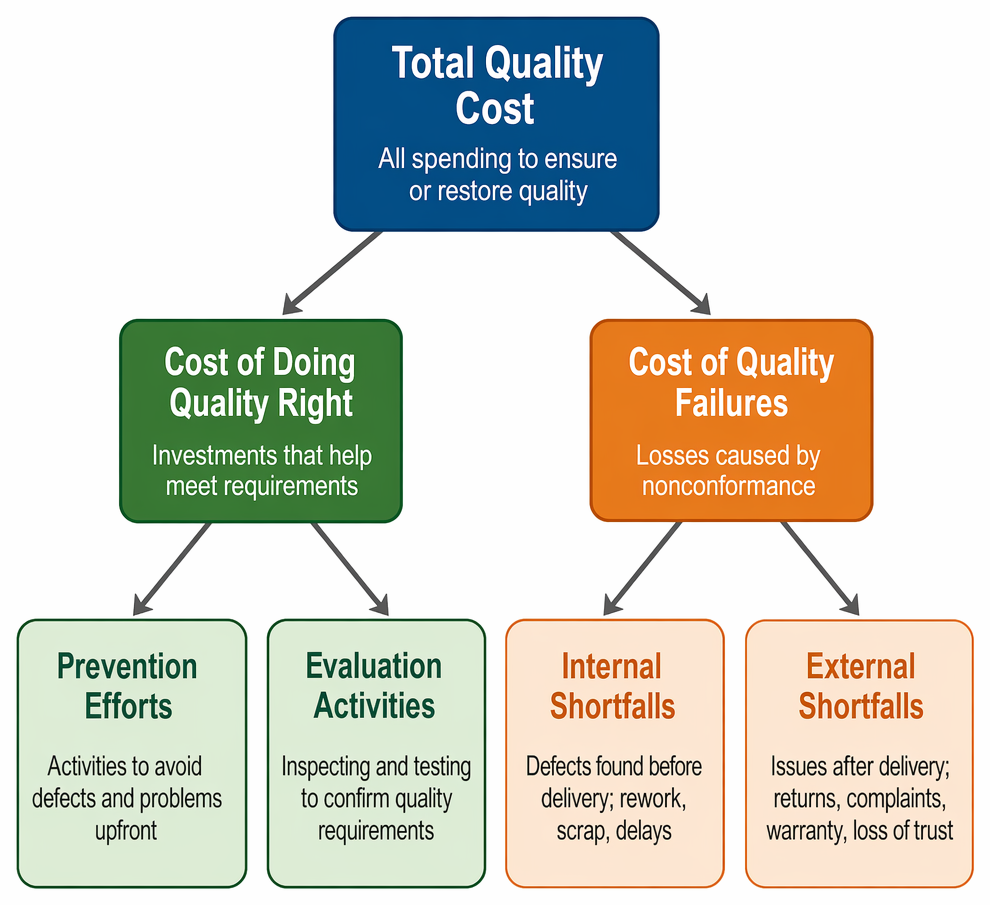

Cost of quality classification into conformance and nonconformance costs, with prevention, appraisal, internal failure, and external failure components.

Cost of quality is decomposed into conformance costs—prevention and appraisal—and nonconformance costs—internal and external failure.

Quality in Project Management

Delivering quality is more than inspection at the end of a process. Quality must be planned and managed throughout the project's life cycle.

Key Term: Quality
The degree to which a set of characteristics of a product, service, or process fulfills requirements. Key Term: Quality Management Plan
A component of the project management plan describing how quality requirements and standards will be defined, achieved, measured, controlled, and reported in the project.

Why Plan for Quality?

Planning quality determines how you will satisfy the requirements—by prevention, measurement, and correction if necessary. Poor planning can lead to defects, rework, wasted resources, delays, and customer dissatisfaction.

Elements of a Quality Management Plan

A robust quality management plan typically includes:

  • Quality standards and criteria
  • Quality roles and responsibilities
  • Metrics for measuring quality
  • Processes for continuous improvement
  • Testing and inspection plans
  • Required documentation and compliance procedures

Key Term: Quality Metrics
Specific, agreed-upon measures of project or product quality (e.g., number of defects, tolerance limits, customer satisfaction score).

Cost of Quality

Every project must balance the cost of doing quality work against the cost of poor quality.

Key Term: Cost of Quality (COQ)
The total costs incurred to prevent, detect, and address nonconformance to requirements—includes prevention, appraisal, and failure costs.

Costs of quality are divided into two main categories:

  • Cost of conformance: prevention (training, standards), appraisal (inspections, testing)
  • Cost of nonconformance: internal failure (rework, scrap), external failure (returns, warranty claims, reputational loss)

Prevention Over Inspection

It is far more effective and affordable to build quality in than to fix problems after they occur.

Quality in Predictive vs. Agile Projects

  • In predictive projects, quality requirements are specified upfront. Compliance, testing, and documentation are planned in advance.
  • In agile projects, quality is achieved through small, frequent deliverables, regular feedback, continuous testing, and short cycles of review and improvement.

Worked Example 1.1

A project team is constructing a new medical device. Regulatory standards require 100% compliance with strict safety criteria. The project manager is building a quality management plan. How should these compliance requirements be treated?

Answer:
All compliance requirements must be included as "must-have" quality criteria, with clear metrics and verification steps defined in the quality management plan. Proactive planning is critical; do not treat compliance as optional or leave it to be addressed during execution.

Quality Tools and Techniques

Quality planning uses several key tools and methods:

  • Checklists and Checksheets: Confirm that all steps and requirements are met during activities or inspections.
  • Cause-and-Effect Diagrams (Fishbone, Ishikawa): Identify root causes of defects or problems, categorizing them (e.g., by people, methods, machinery, materials, measurement, environment).
  • Control Charts: Determine whether a process is stable, shows trends, or is “out of control” (points outside defined limits or 7 consecutive measurements on one side of the mean).
  • Histograms and Pareto Charts: Visualize defect frequency and help prioritize which issues to address first. "Pareto" illustrates the 80/20 rule—fixing the top 20% root causes removes 80% of defects.
  • Scatter Diagrams: Reveal correlation between two variables (e.g., temperature vs. error rate).

Key Term: Control Chart
A diagram showing process results over time, tracking whether output stays within acceptable (control) limits, and helping detect cause for unusual variations.

Continuous Improvement

Modern quality management involves an ongoing effort to improve products, services, and project processes.

Key Term: Continuous Improvement
The ongoing practice of seeking ways to improve project processes, deliverables, and results. Common methods include Kaizen, Total Quality Management (TQM), and Six Sigma.

Agile Quality and Continuous Improvement

Agile projects use frequent reviews, retrospectives, and feedback loops to find problems early and implement improvements regularly.

Worked Example 1.2

The delivery team releases a new software feature every two weeks. After customer feedback at a demo reveals several usability issues, the team adds a checklist and holds brief daily defect reviews for each new feature. Over the next month, defect reports drop by 50%. What continuous improvement principle is demonstrated?

Answer:
The team responded to feedback, examined their process, put in a preventive checklist, and implemented early/frequent inspection. This is continuous improvement in practice.

Exam Warning: Don't rely on inspecting quality in at the end—the PMP exam often tests whether you recognize that planning and building quality in from the start (prevention) is always preferable and less expensive than repeated inspection or fixing defects late.

Common Quality Management Methods

  • Kaizen: Seeks incremental improvements, driven by all team members.
  • TQM (Total Quality Management): Focuses on continuous improvement across the whole organization.
  • Six Sigma: Strives for near-perfect output using statistical analysis and standard deviation (typically aiming for fewer than 3.4 defects per million opportunities).

Planning for Testing and Acceptance

Testing and acceptance procedures should be defined during planning, not left until work is complete. Define who will inspect, what will be measured, and how acceptance will be documented.

Agile: Definition of Done

In agile quality planning, teams use the "definition of done" to clarify what "complete" means for each deliverable, ensuring agreement and testability.

Key Term: Definition of Done
An explicit, agreed-upon set of criteria that must be met before a deliverable or product increment is considered complete and ready for customer use.

Regulatory Compliance and Quality

When regulatory requirements exist, quality planning must treat them as mandatory ("must-have") and define how compliance will be achieved and proven.

Quality Planning and Project Constraints

Plan quality in with explicit consideration for scope, schedule, cost, and risk. For example, a project that cuts quality inspections to save time often risks increased rework, customer complaints, and ultimately higher costs.

Worked Example 1.3

In a rush to launch before a deadline, a construction team skips final quality checks on a new commercial building. After opening, serious safety risks are found, resulting in expensive rework and reputational damage. What lesson should the project manager have learned from quality management principles?

Answer:
Skipping quality inspection and relaxing standards to meet a schedule can cause greater costs and problems later. Planning and controlling quality is always critical, especially where safety is a factor.

Revision Tip: For the PMP exam, be able to explain both "cost of conformance" and "cost of nonconformance," and to distinguish between prevention and inspection. Know the common quality tools (especially checklists, fishbone diagrams, control charts, and Pareto analysis).

Summary

Planning and managing quality in a project is not optional—it's a core, continuous activity. Quality must be built in and verified using planned standards, clear metrics, and effective tools. PMP exam questions on quality expect you to distinguish between prevention and inspection, define cost of quality, and apply continuous improvement. Both predictive and agile projects require documented quality management, ongoing measurement, and proactive improvement.

Key Point Checklist

This article has covered the following key knowledge points:

  • Quality must be planned into the project and deliverables—not inspected in at the end.
  • The quality management plan describes how standards, metrics, testing, and compliance will be achieved and measured.
  • Cost of quality includes both prevention/appraisal and failure (internal/external).
  • Prevention is preferred over inspection—building quality in is less costly than fixing problems late.
  • Continuous improvement (Kaizen, TQM, Six Sigma) is essential for sustainable quality.
  • Quality metrics, checklists, control charts, and cause-and-effect diagrams are practical tools for assurance and control.
  • Agile projects use frequent feedback, "definition of done," and retrospectives for ongoing quality.
  • Regulatory compliance requirements must be treated as mandatory in quality planning.
  • Testing and acceptance should be clearly defined in quality management plans.

Key Terms and Concepts

  • Quality
  • Quality Management Plan
  • Quality Metrics
  • Cost of Quality (COQ)
  • Control Chart
  • Continuous Improvement
  • Definition of Done
